Spannberg substation
Wind power & photovoltaic systems: the Weinviertel region is one of the hotspots for renewable energies in Austria. In the coming years, more and more green electricity will be generated in the region than is consumed. APG is building the new 380/110 kV Spannberg substation, among other things, to facilitate the transport of the surplus production. The new plant will also ensure that the usual high quality of supply is maintained.
99.99% - Austria's supply security is among the best in the world
The project is part of the 9 billion euro investment program, under which APG will expand and strengthen the nationwide high-voltage network (lines and substations) in Austria by 2034. Details about the upcoming construction start will follow soon.
Project ticker
All current information about the project at a glance.
Project ticker
All current information about the project at a glance.
- Update
- Milestone
The preparatory work started mid-October
A new bridge over the Sulzbach and an access road for heavy goods vehicles will relieve the burden on the town centers and protect the cycle path. In addition, earthworks have begun (removal and leveling of the terrain to create a flat surface).
Weinviertel Energy Hub Expands: Construction Work at the Spannberg Substation Is in Full Swing
APG and Netz Niederösterreich Report Positive Interim Results
About a year after the groundbreaking ceremony, construction work on the new 380/110/30-kV Spannberg substation by APG and Netz NÖ is proceeding according to plan. This joint project by the two grid operators is a key component in securing the long-term electricity supply in the Weinviertel region and strengthens the integration of local renewable wind and solar power into the Austrian energy system. A key factor in this is the integration of the new substation into the existing APG Weinviertel transmission line, which will connect the region to the nationwide transmission grid in the future. The first large transformer, weighing 290 metric tons, will be delivered at the end of November.
Visible Progress on the Construction Site
“Despite challenging conditions, including an exceptionally heavy rainstorm in August and last summer’s record-breaking heat, we have been able to stay on schedule so far,” reports Christof Schweer, who is leading the construction of the 380-kV facility on behalf of APG. The first partial commissioning of the new Weinviertel substation is planned for late 2028, with full completion scheduled for mid-2029. “Construction progress is now clearly visible. Particularly noticeable are the extensive site preparations, the construction of the transformer foundations with their associated firewalls, and the striking southern retaining wall. This wall extends for about 250 meters and reaches a height of approximately seven meters,” the project manager continues. Work on the operations building and an internal access road has also already begun.
Upcoming Heavy Hauls: First Large Transformers to Arrive at Spannberg Soon
“A special milestone is already on the horizon in the coming weeks,” Schweer said enthusiastically: “In December and January, the first two 380/110-kV large transformers will be delivered. Each weighs about 290 metric tons and measures approximately 11 meters in length, 4 meters in width, and 4.6 meters in height.” The final leg of the journey, from the Dürnkrut train station to the construction site in Spannberg, will be carried out via a spectacular road transport. A third 380/110-kV transformer will be delivered in the first half of 2028.
Forfurther information and details, see the press release.
Images
Groundbreaking Ceremony at the Spannberg Substation
The Next Major Step Toward a Renewable Energy Future
Spannberg is set to become a central hub in Lower Austria’s energy landscape. Austrian Power Grid (APG) and Netz Niederösterreich GmbH (Netz NÖ) are constructing a new grid node south of the Sulzbach stream, directly on the municipal border with Velm-Götzendorf. The aim is to safely integrate renewable electricity from wind and solar power into the regional supply network. The first power is expected to flow through the new facilities in mid-2028, with full completion scheduled for mid-2029.
The new Spannberg substation will channel renewable electricity generated in the region between Mistelbach and Dürnkrut into the extra-high-voltage grid. By linking Netz NÖ’s existing substation with APG’s nationwide transmission network, it will help maintain the high security and quality of supply for generations to come.
“The use of renewable energy sources in our own country is another important step toward reducing import dependency, strengthening regional value creation, and supporting Lower Austria as an economic location,” emphasizes René Lobner, Member of the Lower Austrian Parliament, speaking on behalf of Governor Johanna Mikl-Leitner.
For full details, please see the press release Groundbreaking Ceremony at the Spannberg Substation.
Images
Past meets future
Large crowds at the "Open Excavation Day": visitors find out about finds & construction project

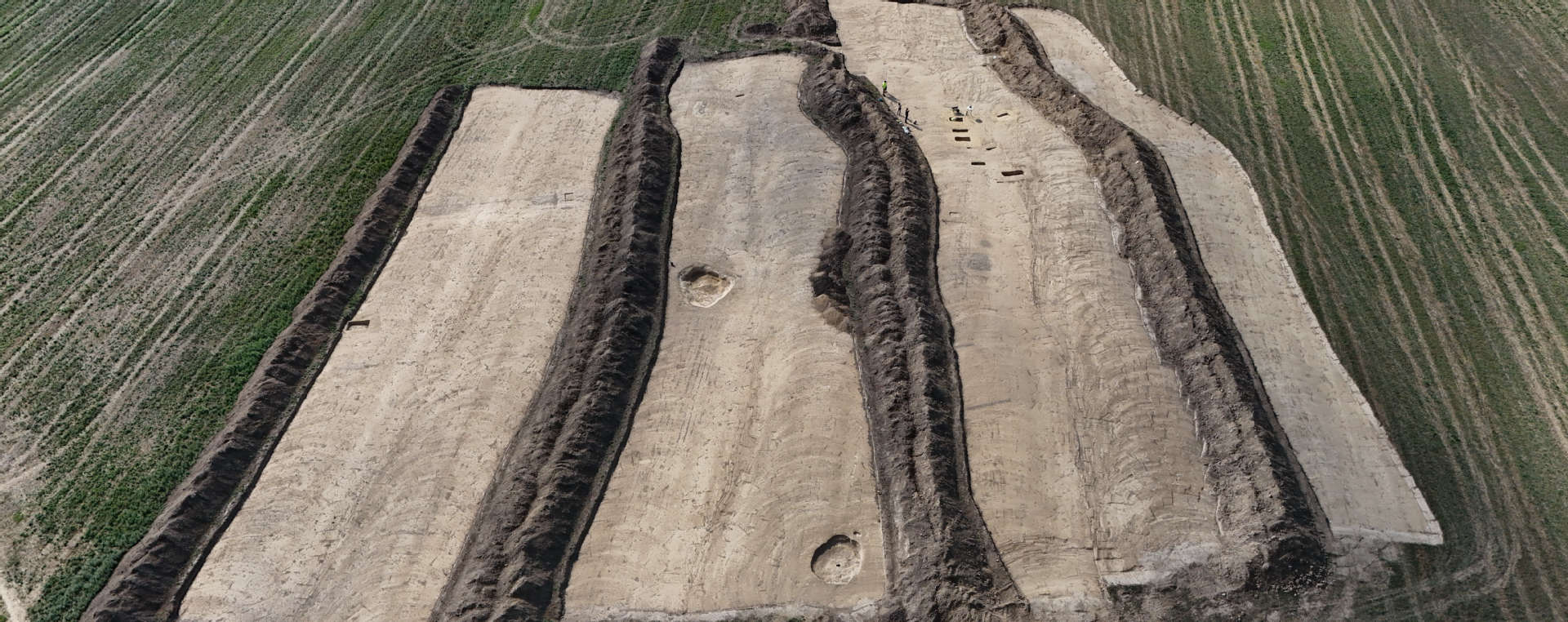

On October 3, more than 200 visitors marveled at the numerous archaeological finds that have been uncovered on the APG construction site since August and made accessible to the public on this day as part of guided tours:
- The finds from the Neolithic period include fragments of pottery and a grindstone that was used to process grain into flour.
- The people buried in the cemetery were given grave goods. These included ceramic vessels, costume items such as buckles, jewelry such as glass beads and food offerings. These grave goods were typical for graves from the early Middle Ages.
- A pot with wavy lines of decoration is attributed to the so-called Danube type, which was popular in our region from the 8th and 9th centuries. Everyday objects also found their place. It was easy to light a fire with a fire steel and flints. An iron bracket and elongated iron fragments show the remains of a small wooden bucket. Fragments of knives were also found in several graves.
Start of construction for security of supply
In addition to the archaeologists, experts from APG spoke at the event about the importance of the new Spannberg substation for the regional electricity supply and the secure, affordable energy transition in Austria. The project is part of the EUR 9 billion investment program to strengthen the Austrian extra-high voltage grid by 2034, as part of which APG is expanding and converting its lines and substations.
"With the new Spannberg substation, we are creating a direct connection between Netz Niederösterreich's distribution grid and APG's Austria-wide electricity grid. This will secure the electricity supply in the region for the coming decades. In addition, surplus wind and solar power that is not consumed locally can be distributed and used throughout Austria in future," explains Christoph Guldner, who is managing the project for APG. And he adds: "The preparatory construction measures such as bridge construction and building the access road will start in mid-October. Commissioning of the first parts of the plant is planned for the end of 2028, with overall completion scheduled for mid-2029."
The responsible treatment of natural and cultural assets is part of all network infrastructure projects at APG, which cooperates with the Federal Monuments Office and archaeological experts as standard during project development - especially in eastern Austria, where experience has shown that significant historical traces are discovered.
Images
Open excavation day
On Friday, October 10, 2025, APG invites you to the open excavation day at the future Spannberg substation. Experience archaeologists live at work at the excavation site. The program includes guided tours, an exhibition of selected finds and an immersion into the exciting world of electricity supply. Visit us & take a look behind the scenes of the excavation site!
Date: Friday, 3. October 2025, 2:30 pm
Duration: approx. 90 minutes
Location: Meeting point at the blue construction container
Am Bach, 2244 Spannberg
Project Roadmap
Transmission of submission documents
The submission documents are sent to the authority.
Archaeological excavations
Survey of the construction site on an area of 8,000 m2
Preparatory construction measures
Bridge construction over the Sulzbach and construction of the access road.
Main construction phase
Construction of transformer foundations, operations building, retaining wall and earthworks.
Delivery of large transformers
3x 380/110 kV transformers
Commissioning
Completion of the facility.
